Decommissioning and asset disposal: six stages from the decision to the closed records
Decommissioning done deliberately: the decision and the function it settles, the plan, making safe with nothing on an assumption, removal, reinstatement, and closing every record that said the asset existed. The six questions a disposal answers before the asset leaves, how mothballing differs from abandonment, and where it goes wrong.

Key takeaways
- Decommissioning is the last stage of an asset's life and the one most often done by accident. Done deliberately it is six stages, each with a gate, from the decision to the closed records.
- The decision comes first and is recorded with its basis. What happens to the function the asset served is settled before anything is switched off.
- Make safe is the stage nothing passes on an assumption: every energy source and every process connection isolated, verified and written down.
- Disposal answers six questions before the asset leaves: what still depends on it, what it is worth, what hazards it carries, what data is on it, what obligations attach, and which records still say it exists.
- An asset is not gone until every system says so. The register, the CMMS, the spares, the drawings, the control system, the ledger and the insurer's schedule are each closed, and the history is kept.
Most plants have a dead asset somewhere. A pump that was replaced and left in place, still on the register, still generating preventive work orders that get cancelled every month, still insured, with a live cable landed in its starter because nobody was sure. It was never decommissioned. It was just stopped, and stopping is not the same thing.
Decommissioning is the last stage of the asset life cycle, and it is done deliberately or it is done badly. This guide sets out the six stages from the decision to the closed records, with the gate at the end of each, the six questions a disposal answers before the asset leaves, what has to leave which system when an asset is retired, how mothballing differs, and where it goes wrong. It is written for the plant engineer taking one asset or one system out, which is the common case, and the shape holds for a whole facility with the regulator's conditions added.

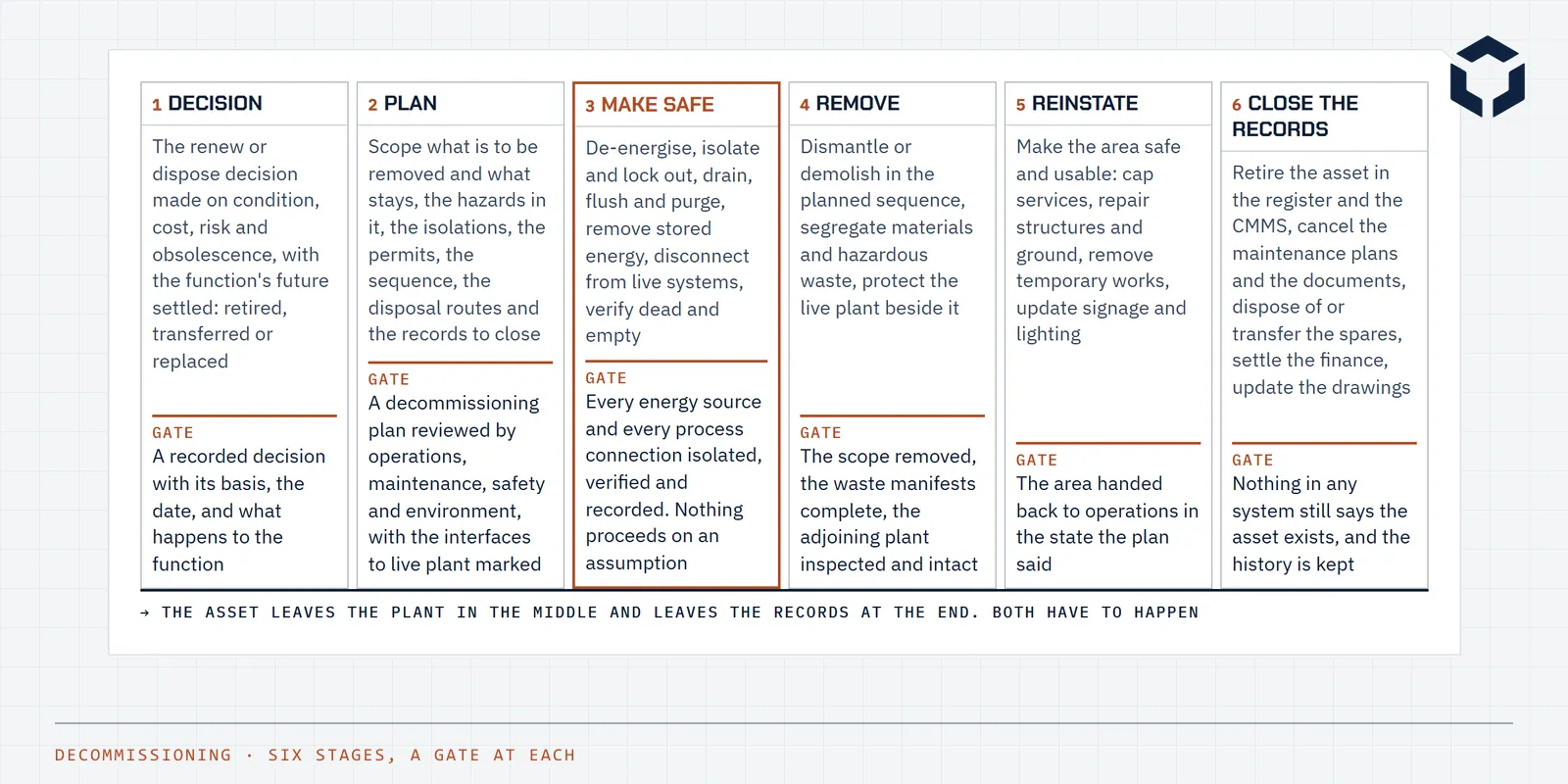

The six stages and their gates
The stages are a sequence with a gate at the end of each, the same shape as commissioning run in reverse. The decision comes first and is recorded. The plan scopes what goes and what stays, which on a brownfield site is the hard part, because the asset shares cable trays, pipe racks, supplies and controls with the plant that keeps running. Make safe is the gate that is never passed on an assumption. Removal, reinstatement and the records each close in turn.
The owner changes along the way, which is where things are dropped. The asset owner decides, engineering plans, operations makes safe, a contractor removes, the project reinstates, and asset management and finance close the records. The decommissioning plan names who holds each gate, and the last gate is the one most often left to nobody.
1Decision
The renew or dispose decision made on condition, cost, risk and obsolescence, with the function's future settled: retired, transferred or replaced
Gate
A recorded decision with its basis, the date, and what happens to the function
2Plan
Scope what is to be removed and what stays, the hazards in it, the isolations, the permits, the sequence, the disposal routes and the records to close
Gate
A decommissioning plan reviewed by operations, maintenance, safety and environment, with the interfaces to live plant marked
3Make safe
De-energise, isolate and lock out, drain, flush and purge, remove stored energy, disconnect from live systems, verify dead and empty
Gate
Every energy source and every process connection isolated, verified and recorded. Nothing proceeds on an assumption
4Remove
Dismantle or demolish in the planned sequence, segregate materials and hazardous waste, protect the live plant beside it
Gate
The scope removed, the waste manifests complete, the adjoining plant inspected and intact
5Reinstate
Make the area safe and usable: cap services, repair structures and ground, remove temporary works, update signage and lighting
Gate
The area handed back to operations in the state the plan said
6Close the records
Retire the asset in the register and the CMMS, cancel the maintenance plans and the documents, dispose of or transfer the spares, settle the finance, update the drawings
Gate
Nothing in any system still says the asset exists, and the history is kept
→ The asset leaves the plant in the middle and leaves the records at the end. Both have to happen
| Stage | What it does | The gate | Owner |
|---|---|---|---|
| Decision | The renew or dispose decision made on condition, cost, risk and obsolescence, with the function's future settled: retired, transferred or replaced | A recorded decision with its basis, the date, and what happens to the function | Asset owner |
| Plan | Scope what is to be removed and what stays, the hazards in it, the isolations, the permits, the sequence, the disposal routes and the records to close | A decommissioning plan reviewed by operations, maintenance, safety and environment, with the interfaces to live plant marked | Project or maintenance engineering |
| Make safe | De-energise, isolate and lock out, drain, flush and purge, remove stored energy, disconnect from live systems, verify dead and empty | Every energy source and every process connection isolated, verified and recorded. Nothing proceeds on an assumption | Operations, with maintenance |
| Remove | Dismantle or demolish in the planned sequence, segregate materials and hazardous waste, protect the live plant beside it | The scope removed, the waste manifests complete, the adjoining plant inspected and intact | Contractor under the site's permit system |
| Reinstate | Make the area safe and usable: cap services, repair structures and ground, remove temporary works, update signage and lighting | The area handed back to operations in the state the plan said | Project |
| Close the records | Retire the asset in the register and the CMMS, cancel the maintenance plans and the documents, dispose of or transfer the spares, settle the finance, update the drawings | Nothing in any system still says the asset exists, and the history is kept | Asset management, finance |
The decision, and the function
The renew or dispose decision is made on condition, performance, cost, risk and obsolescence, and recorded with its basis. Decommissioning begins from that record, not from the day the asset stops. The first thing the record has to settle is the function: what the asset did, and whether that function is retired with it, transferred to something else, or replaced by a new asset that is commissioned before the old one is removed.
The function question is where the tie-ins hide. A pump that is retired may have been the standby for its twin, the source of seal water for something else, or the one protection in a loop that nobody remembers. The P&IDs, the single lines and the cause and effect are read before the decision is final, which is one reason document control matters at the end of a life as much as at the start.
Decide what happens to the function before deciding what happens to the asset. The asset is the easy part.
Make safe: nothing on an assumption
Making safe is where decommissioning hurts people, and the hazards are the ordinary ones: a cable still live because the isolation was at the wrong breaker, a line still pressurised because the drain was blocked, a vessel still holding product under a crust, a spring or a counterweight still loaded, a motor still able to be started from a remote station nobody isolated. Each energy source and each process connection is isolated, locked, verified by test, and recorded against the plan, under the site's permit system. Then it is disconnected, so that no later mistake can re-energise it.
Hazardous materials are identified before the first bolt comes out: asbestos in older plant, lead paint, refrigerants, oils and residues, radiation sources in level gauges, batteries in UPS cabinets. The survey decides the removal method and the disposal route for each, and the national model code of practice for demolition work sets out the obligations that follow. A contractor working to the site's permits and the plan, with the live plant beside the work protected, is the removal stage.
Disposal: six questions before it leaves
Disposal is the one stage with a cheque attached, in either direction. A machine in fair condition may be worth more to a sister site or a buyer than as scrap, and a large item may cost more to make transportable than it is worth. The questions below are answered before the asset moves, and the answers are recorded with the decision, because the residual value and the disposal cost both go to the ledger.
Two of the questions are newer than the others. Control equipment carries the site's logic and credentials and is wiped or stripped of its storage before it leaves; the OT security inventory is the list to check. And the environmental and regulatory obligations, waste tracking, the conditions on the site's approvals, and for a mine the closure plan, have to be met and evidenced, which is slower than the removal itself.
| Question | Asks | Answered from |
|---|---|---|
| Function | Does anything still depend on it: a tie-in, a protection, a spare for its twin? | The P&IDs, the single lines, the spares register |
| Value | Is it worth more sold, transferred to another site, kept as a spare, or scrapped? | Condition, age, market, the cost of making it transportable |
| Hazards | What is in it, on it and around it: residues, asbestos, lead paint, refrigerants, stored energy, radiation sources? | The hazardous materials survey, the datasheets, the process history |
| Data | What is on it: a control system with the site's logic, a drive with network credentials, a laptop in the panel? | The control system inventory. Wiped or removed before it leaves |
| Obligations | What must be reported, licensed or remediated: environmental approvals, mine closure conditions, waste tracking? | The site's approvals and the regulator's conditions |
| Records | Which systems still say it exists: the register, the CMMS, the finance ledger, the drawings, the insurer's schedule? | The document register and the asset register |
Closing the records
An asset is gone from the plant when it is removed, and gone from the organisation only when every system that described it says so. The table lists the usual systems and what leaves each. Nothing is deleted: the register entry goes to retired with the date and the reference, the CMMS history stays against the closed functional location, and the drawings are revised or cancelled with the decommissioning record filed. Deleting a retired asset is how the reliability engineer loses the failure history of the one that replaced it.
The records stage is the one most often left undone, because the project has finished and the asset is physically gone, and the consequence is slow: preventive work orders generated and cancelled for years, spares held for a machine that does not exist, an insurance premium on a hole in the ground, a drawing with a pump on it that someone one day designs around. The asset register guide sets out the register's side of it.
| System | What happens to it | Who |
|---|---|---|
| Asset register | Status to retired with the date and the disposal reference. Never deleted | Asset management |
| CMMS | Functional location closed, maintenance plans deactivated, open work orders cancelled with a reason, history kept | Planner |
| Spares and bill of materials | Spares unique to the asset disposed of or transferred; shared spares re-pointed to what remains | Store and reliability |
| Documents | Drawings revised to remove the asset, or cancelled where the whole system goes; the decommissioning record filed | Document control |
| Control system | Logic, displays and alarms removed; I/O spared; the backup taken before and after | Control engineering |
| Finance | Written off or sold, with the residual value and the disposal costs booked | Finance |
| Insurance and compliance | Removed from the insured schedule and the statutory inspection register | Asset management |
Mothballing is a decision too
Some assets are taken out of service with the intent of coming back: a second crushing line when demand falls, a plant waiting for a permit. Mothballing is a decision like decommissioning, with its own plan. The asset is isolated and made safe the same way, then preserved rather than removed: protected against corrosion and ingress, rotated or inhibited where it has bearings or oil, inspected on a reduced maintenance plan that stays live in the CMMS, and kept on the register and the insurance schedule as mothballed. The return date, or the trigger for one, is written down, and when the trigger passes without a return the decision is made again.
What mothballing is not is leaving the asset in place with the maintenance plans cancelled and the isolations unrecorded. That is abandonment, and it is the state most dead assets are actually in.
Where it goes wrong
- Stopped, not decommissioned: the asset left in place with its hazards and its records intact.
- The function not settled, so a tie-in or a protection that depended on the asset is discovered when it is cut.
- Isolation assumed from the drawing rather than verified by test.
- Hazardous materials found by the contractor's grinder rather than by a survey.
- A controller sold with the site's logic and credentials on it.
- Preventive work orders generated for years on a functional location nobody closed.
- Spares held for an asset that was scrapped, and the twin's spares disposed of with it.
- The record deleted instead of retired, and the history gone with it.
Common questions
What is decommissioning?
The deliberate removal of an asset or a system from service at the end of its life, through making it safe, removing it, reinstating the area and closing its records, so that nothing on the plant or in its systems still depends on it or still says it exists. It is the final stage of the asset life cycle, after the renew or dispose decision, and it is planned and gated like any other project work.
What is the difference between decommissioning, mothballing and abandonment?
Decommissioning removes an asset from service for good and closes it out. Mothballing takes it out of service with the intent of returning it, so it is preserved, isolated and kept on the register and the insurance schedule with a reduced maintenance plan. Abandonment is leaving an asset in place without either decision, which is the common outcome and the worst one, because the hazards stay and the records drift. The decision stage exists to make sure one of the first two is chosen.
What is asset disposal?
What happens to the physical asset once it is decommissioned: sold, transferred to another site, kept as a spare for its twin, or scrapped, with the hazardous materials, the data on it and the environmental and regulatory obligations dealt with before it leaves, and the residual value and disposal cost booked. Disposal is one stage of decommissioning, not the whole of it.
What has to happen before equipment is removed from a plant?
Every energy source isolated and locked, every process connection isolated, drained, flushed and purged as the material requires, stored energy released, the equipment disconnected from live systems, and all of it verified as dead and empty and recorded. Then the hazardous materials on and in it identified, the disposal route for each decided, and the adjoining live plant protected. The make safe gate is the one that is never passed on an assumption.
What records are closed when an asset is retired?
The asset register, with the status set to retired and the disposal reference, never deleted. The CMMS, with the functional location closed, the maintenance plans deactivated and open work orders cancelled with a reason, the history kept. The spares and bill of materials. The drawings, revised or cancelled. The control system, with the logic and alarms removed and backed up before and after. The finance ledger, with the write-off or sale. And the insurance and statutory inspection schedules.
Is a control system a data risk when it is disposed of?
Yes. A PLC, an HMI, a drive or a laptop in a panel can hold the site's logic, network configuration and credentials, and a decommissioned controller sold or scrapped with that on it is a path into the plant that still runs. Control equipment is wiped or its storage removed before it leaves, and the control system inventory is the list of what to check. The OT security guide covers the inventory that makes this possible.
Key terms
Plain-language definitions from our glossary for the concepts this article leans on.
Standards and further reading
- ISO 55001:2024 Asset management system requirements (ISO)
- ISO 55000:2024 Asset management: vocabulary, overview and principles (ISO)
- Model Code of Practice: Demolition work (Safe Work Australia)
- AS 2601-2001 The demolition of structures (Standards Australia)
- IEC 60300-3-3:2017 Dependability management: application guide, life cycle costing (IEC)
Related case studies and tools
- Life Cycle Cost Calculator (tool)
- Asset management planning and the system behind it (case study)
