Shutdown planning: the checklist, the scope freeze and the schedule that holds

A shutdown is the most expensive week in a maintenance year, and its cost is decided months out. The timeline and its gates, where scope comes from and how it is challenged, what the scope freeze does, how jobs become a resourced schedule, readiness proven at gates, execution control and close-out, with a free checklist workbook.

Planning & SchedulingWork ManagementMaintenance Strategy

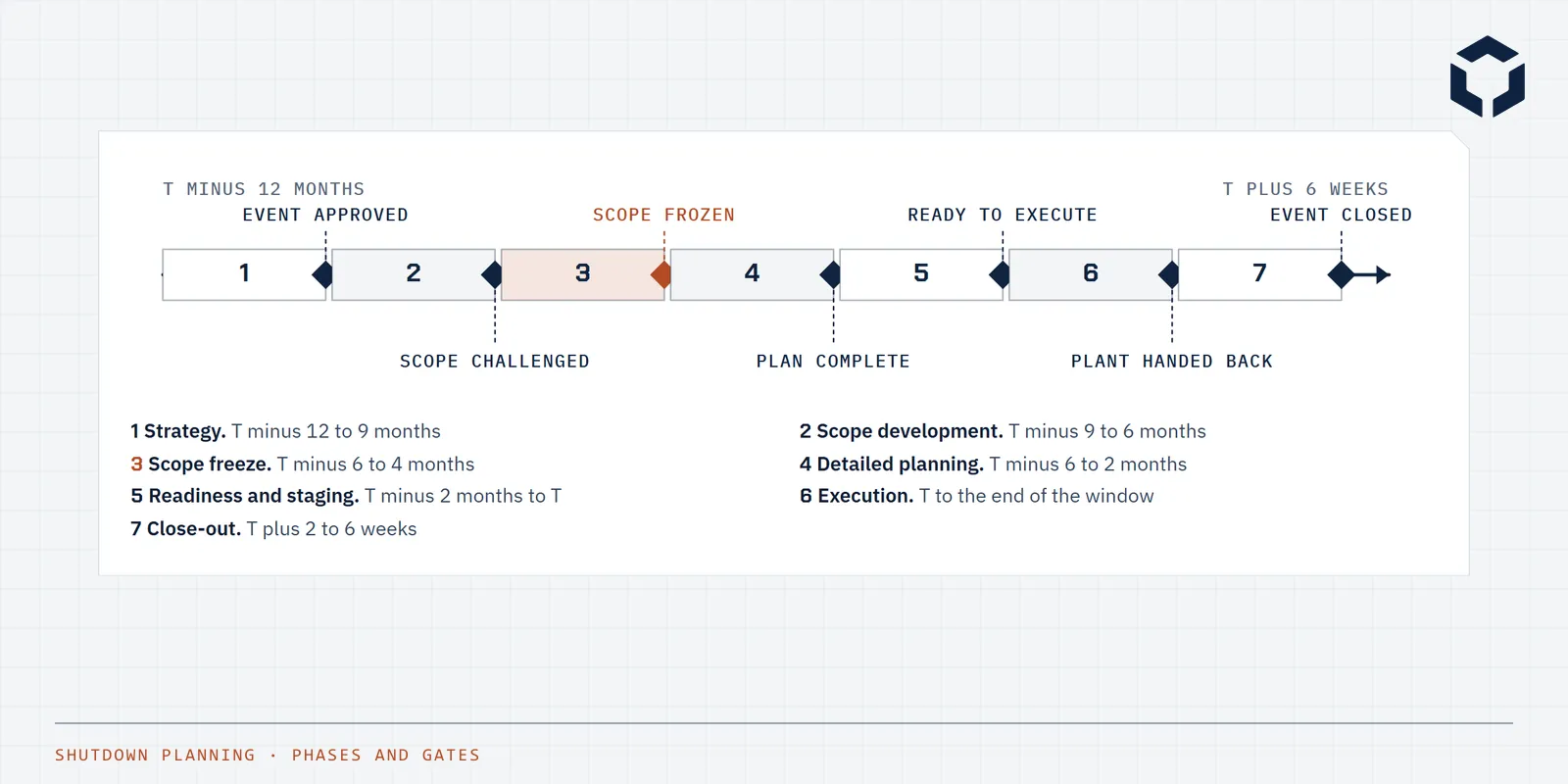

Line drawing of a shutdown timeline from twelve months out to close-out, with a gate at the end of each phase and the scope freeze marked

Key takeaways

  • A shutdown is the most expensive week in a maintenance year, and almost all of its cost is decided months before it starts, in what goes into the scope and when it is frozen.
  • Scope comes from evidence: strategy tasks due in the window, wear measurements, inspection findings and projects. Everything else is challenged, and what fails the challenge is deferred with a reason.
  • The scope freeze is the single decision that separates shutdowns that finish on time from those that grow on the day. After it, every addition goes through one approval path and is counted.
  • Planning turns the frozen scope into job packs, an isolation plan, access bookings and a resourced schedule with a critical path. Readiness is proven by evidence at gates, not by percentages.
  • Close-out is where the next event starts: wear life back into the intervals, history into the CMMS, and the first items on the next scope register.

A shutdown is the most expensive week in a maintenance year. The plant stops earning, several hundred people arrive at once, and every hour of the window has a production figure attached to it. Almost all of that cost is decided months before the first isolation, in what goes into the scope, when it is frozen, and how honestly readiness is proven.

The pattern that goes wrong is familiar. The scope list grows until the week before, long lead parts arrive late because they were ordered against a moving target, the first two days are spent finding things, and the event runs over while the business asks why. None of that is bad luck. It is a planning method with the gates missing.

This guide sets out the method: the timeline and its gates, where scope comes from and how it is challenged, what the scope freeze does, how a job becomes a plan and a plan becomes a schedule, what readiness looks like at each gate, how execution is controlled, and what close-out has to leave behind. The checklist that runs through it is available as a free workbook.

Free download

Shutdown planning checklist

The readiness checklist from this guide as a workbook: every item by phase, with the gate it belongs to, the evidence that closes it, an owner and a status, plus a scope register and an addition log.

Download (Excel, 17 KB)

Shutdown, turnaround, outage

The names change by industry and the event does not. A planned stop of a continuous operation to do the work that cannot be done while it runs: relines, liner and screen changes, belt splices, vessel inspections, tie-ins for projects, and the statutory and assurance work that needs the plant cold. Mining says shutdown, oil and gas says turnaround, power says outage.

What makes it different from routine maintenance is concentration. Work that would take a crew a year is done by several crews in a week, in the same space, under the same permits, on the same critical path. That concentration is why planning has to run on gates, with each phase ending in a decision that is evidenced rather than assumed.

EventTypical durationTypical cycleWhat sets the cycle
Short stop on a crushing or screening plant8 to 24 hoursWeekly to monthlyScreen media and liner wear by the tonne
Processing plant shutdown3 to 10 daysQuarterly to annualMill reline interval and the longest-lived shutdown-bound task
Refinery or gas plant turnaround3 to 8 weeks3 to 6 yearsStatutory inspection intervals and catalyst life
Rail possessionHours to daysScheduled in the access planTrack and structures work that needs the line closed

The timeline, and the gates on it

A major event runs on a timeline of nine to twelve months, and each phase ends at a gate. The gate is a decision with evidence behind it: the event is approved, the scope has been challenged, the scope is frozen, the plan is complete, the site is ready, the plant is handed back, the event is closed. Shorter events compress the timeline but keep the gates.

The windows below suit a quarterly or annual processing plant shutdown. The point is the order, and the discipline of not opening the next phase until the gate behind it is closed. A site that starts detailed planning before the scope is frozen plans twice.

  1. 1Strategy. T minus 12 to 9 months
  2. 2Scope development. T minus 9 to 6 months
  3. 3Scope freeze. T minus 6 to 4 months
  4. 4Detailed planning. T minus 6 to 2 months
  5. 5Readiness and staging. T minus 2 months to T
  6. 6Execution. T to the end of the window
  7. 7Close-out. T plus 2 to 6 weeks
Fig. 1 · The seven phases of a shutdown and the gate each one ends with
PhaseWindowGate it ends with
StrategyT minus 12 to 9 monthsEvent approved
Scope developmentT minus 9 to 6 monthsScope challenged
Scope freezeT minus 6 to 4 monthsScope frozen
Detailed planningT minus 6 to 2 monthsPlan complete
Readiness and stagingT minus 2 months to TReady to execute
ExecutionT to the end of the windowPlant handed back
Close-outT plus 2 to 6 weeksEvent closed

Where scope comes from, and the challenge

Scope comes from evidence. The maintenance strategy says which tasks fall due in the window. Wear measurements on liners, screen media, idlers and wet ends say which are actually at the end of their life. Inspection and condition monitoring findings say what has deteriorated. Projects say what needs a tie-in. The deferral log from the last event says what was promised. Everything else, and there is always everything else, is a candidate until it has a justification.

The scope challenge is the meeting where each candidate is asked three questions. Can it be done online, between events, so it does not need the window at all? Can it wait for the next event without a consequence worth the cost of doing it now? If it must be done now, what happens if it is not? The answers are recorded on the scope register beside the item, and the items that fail the challenge are deferred with a reason rather than quietly kept.

This is the step that most reduces an event's cost, and the one most often skipped. A scope register that was never challenged is a wish list with a budget, and the challenge cannot happen without the wear data and the strategy behind it, which is why fixed plant maintenance between events matters so much to the event itself.

  • One register, one owner, with a source and a justification against every line.
  • Measure wear parts before the challenge, not before the freeze. The measurement is the evidence.
  • Separate must-do, should-do and could-do, and plan the could-do as contingency scope that goes ahead only if the critical path allows.
  • Give project tie-ins the same challenge as maintenance work. A project's window is not a reason by itself.

A scope list that has not been challenged is a wish list with a budget attached.

The scope freeze

The scope freeze is a signed decision that the register is now the scope, and that anything added after it is an addition. It is set by the longest lead time in the scope, because long lead materials and contract packages have to be ordered and tendered against a fixed list, and for a major event that puts the freeze four to six months out. Everything that follows, from job packs to the schedule to the kitting, is built against the frozen list.

Freezing does not mean nothing changes. It means every change goes through one approval path, is judged on consequence and on what it does to the critical path, and is counted. The addition process is defined at the freeze, with a named approver and a form of evidence, so when a discovery during the work or a request from a manager arrives, there is a path and a record rather than an argument.

Scope growth after the freeze, as a share of the frozen scope, is the measure that tells a site whether its planning is improving across events. Reported honestly, it is usually the most uncomfortable number in the close-out report and the most useful.

From a line on the register to a job that can be done

Every item on the frozen scope becomes a work order with a job pack: the steps, the trades and durations, the materials, the permits and isolations, the access and lifting, and the drawings and procedures the crew will work from. On a shutdown the pack also carries what the routine week does not: the sequence against other jobs in the same area, the scaffold and crane it depends on, and the test it has to pass before the item is closed.

The isolation plan comes from the packs. Isolations are grouped so one set of locks serves many jobs, long isolations are pre-approved, and the order in which systems come down and go back up is agreed with operations. Access is designed the same way: a scaffold plan, crane and lift studies, lay down areas and a traffic plan, each booked and each on the schedule as a task in its own right.

Pre-shutdown work is the last step of planning and the first of execution. Scaffold erected while the plant runs, components pre-assembled, lay down areas set and the first shifts' permits written take hours off the critical path that would otherwise be spent on the most expensive days of the year.

The schedule, the critical path and the people

The schedule is built from the job packs, not the other way round. Each pack supplies durations, trades and dependencies, the scheduler levels the work against the shift pattern and the crews, and the critical path falls out: the chain of jobs that sets the duration of the event. On most processing plant shutdowns it runs through the mill reline, the largest vessel inspection or a structural repair, and it is known months in advance.

Contingency is held deliberately, as time on the schedule and money in the budget, with a rule for who can spend it. A schedule with no float is a forecast of overrun. One with hidden float in every task is a forecast of waste. The contingency sits at the end of the critical path and is spent by decision.

The daily rhythm is set before the event and rehearsed. One meeting a shift, short, with progress by work order against the baseline, the critical path status, the additions requested and decided, and the next shift's priorities. The people who will run it practise on the plan before they run it on the plant.

  • Build the schedule from job packs, with every pack's dependencies and access needs in it.
  • Know the critical path and protect it. Anything that touches it is approved at a higher level.
  • Level resources honestly against the shift pattern, including the hours lost to permits, travel and handover.
  • Hold contingency as a visible block, and spend it by decision.
  • Plan start-up and recommissioning as part of the event, not as what happens after it.

Readiness: proven at gates, not by percentages

Readiness is the question of whether the site can execute the plan from the first shift. It is answered by evidence against each line of the checklist, not by a percentage complete on a tracker. Materials are either received, inspected and kitted by work order, or they are not. Contractors are either inducted and competent on the site's isolation system, or they are not. Permits for the first shifts are either written, or they are not.

The checklist below is the one that runs through this guide. Each line says what has to be true and what proves it, and each phase ends at its gate. The workbook carries the same lines with an owner, a due date and a status against each, plus a scope register and an addition log laid out to match.

PhaseWhat has to be trueWhat proves it
StrategyEvent dates, duration and the production plan it sits inside agreed with operationsApproved event calendar
StrategyBudget envelope and the business case for the event setApproved budget
StrategyShutdown manager, planning lead and scope owners namedRoles on the organisation chart
StrategyLong lead items identified from the strategy tasks due in the windowLong lead list with order dates
Scope developmentEvery candidate item of work collected into one list with a source and a justificationScope register
Scope developmentWear parts measured and intervals checked, so scope rests on condition rather than habitWear measurements on the register
Scope developmentEach item challenged: can it be done online, deferred to the next event, or must it be done nowChallenge decision recorded per item
Scope developmentProjects and capital work that want the window declared and integratedProject scope on the register
Scope developmentScope that failed the challenge removed or deferred with a reasonDeferral log
Scope freezeThe frozen scope signed by operations, maintenance and the shutdown managerSigned freeze document
Scope freezeThe addition process after the freeze defined: who approves, on what evidence, against what consequenceAddition process issued
Scope freezeLong lead materials ordered against the frozen scopePurchase orders with delivery dates before staging
Scope freezeContract packages scoped from the frozen list and tenderedPackages issued
Detailed planningEvery work order has a job pack: steps, trades, durations, materials, permits, isolations and accessJob packs approved
Detailed planningIsolations grouped and the isolation plan draftedIsolation list and plan
Detailed planningScaffold, cranes, lifts and access designed and bookedAccess plan and bookings
Detailed planningSchedule built from the job packs, critical path identified, resources levelledBaseline schedule with critical path
Detailed planningShift pattern, crew sizes and contractor numbers set against the scheduleResource histogram
Detailed planningContingency held as time and money, with the rule for spending itContingency on the schedule and budget
Detailed planningStart-up and recommissioning sequence planned with operationsStart-up plan
Readiness and stagingMaterials received, inspected, kitted by work order and stagedKitting report, nothing outstanding on the critical path
Readiness and stagingContractors mobilised, inducted and competent on the site's permit and isolation systemsInduction and competency records
Readiness and stagingPermits pre-written and isolations pre-approved for the first shiftsPermit and isolation packs
Readiness and stagingPre-shutdown work done online: scaffold up, pre-assembly complete, lay down areas setPre-shutdown checklist closed
Readiness and stagingDaily meeting, reporting and change control rehearsed with the people who will run themMeeting rhythm issued
Readiness and stagingSafety plan, emergency arrangements and simultaneous operations reviewedSafety plan approved
ExecutionProgress measured against the baseline every shift, by work orderShift progress report
ExecutionEvery addition after the freeze goes through the addition process and is countedAddition log with approvals
ExecutionCritical path reviewed every shift and recovery decided when it slipsCritical path status in the daily meeting
ExecutionFindings during the work (discovered scope) assessed for now, later or neverDiscovery log
ExecutionQuality checks and tests signed before any item is closedInspection and test records
Close-outPunch list cleared or converted to work orders with ownersPunch list closed
Close-outWork order history, measurements and as-found condition recorded in the CMMSHistory complete on every work order
Close-outWear life achieved fed back into intervals and the next event's scopeInterval changes logged
Close-outDuration, cost, scope growth, safety and start-up performance reported against planClose-out report
Close-outLessons captured and the first items for the next event registeredLessons register and the next scope register opened

If a checklist line cannot be proven with something you could hand to the next shutdown manager, it is a hope, not a gate.

Execution: holding the plan while the plant is open

Execution is where the plan meets what the plant was actually hiding. Discovered scope is normal, and the discipline is in how it is handled: each finding is logged, assessed for now, later or never, and either added through the approval path or recorded for the next event. The discovery log is as important as the schedule, because it is the evidence behind the next scope register.

Progress is measured by work order against the baseline every shift, and the critical path is reviewed every shift. When it slips, recovery is decided in the meeting, by moving crews, extending a shift or spending contingency, rather than hoped for. Jobs are closed on a signed test or inspection, not on a verbal, and the hand-back to operations follows the start-up plan written months earlier.

The software a site runs this on matters less than the rhythm, but it matters. A shutdown coordination platform that holds the scope, the bookings, the labour and the progress in one place removes the hunt for information that eats the first hour of every meeting.

Close-out is where the next event starts

The event is not over when the plant restarts. The punch list is cleared or converted to work orders with owners. Every work order gets its history: hours, findings, measurements and as-found condition, in the CMMS, so the next planner has data rather than memory. Wear life achieved on liners, media and idlers goes back into the intervals, which is the loop that makes the next scope register smaller and more accurate.

The close-out report puts the event's numbers against its plan: duration, cost, scope growth, schedule adherence by shift, safety, start-up time and losses after hand-back, and rework. Lessons are captured while people remember them, and the first lines of the next event's scope register are opened the same month. A site that does this consistently sees scope growth fall and duration converge on plan across three or four events.

  • Duration against baseline, and where the critical path slipped.
  • Cost against estimate, split between the frozen scope and additions.
  • Scope growth as a share of the frozen scope, by source.
  • Schedule adherence by shift, and the recovery decisions taken.
  • Safety performance, including the near misses.
  • Start-up time and production losses after hand-back.
  • Rework, and what caused it.

Scope growth, reported honestly at close-out, is the number that shows whether the planning is getting better.

Common mistakes

  • A scope register nobody challenged, so the event does work the plant did not need.
  • A freeze set by the calendar rather than by the longest lead time, so planning runs against a moving target.
  • Long lead parts ordered from the scope list instead of from measured wear, and arriving after the window.
  • Job packs that stop at the task description, with access, isolations and tests discovered on the day.
  • A schedule with no visible critical path, so nobody knows which slip matters.
  • Readiness reported as a percentage, with the missing twelve per cent on the critical path.
  • Additions by conversation, uncounted, so scope growth is a feeling rather than a number.
  • No close-out, so the next event starts from a blank workbook and repeats the last one's lessons.

A shutdown, gate by gate

  1. Strategy

    T minus 12 to 9 months. Ends when: event approved.

  2. Scope development

    T minus 9 to 6 months. Ends when: scope challenged.

  3. Scope freeze

    T minus 6 to 4 months. Ends when: scope frozen.

  4. Detailed planning

    T minus 6 to 2 months. Ends when: plan complete.

  5. Readiness and staging

    T minus 2 months to T. Ends when: ready to execute.

  6. Execution

    T to the end of the window. Ends when: plant handed back.

  7. Close-out

    T plus 2 to 6 weeks. Ends when: event closed.

Common questions

What is shutdown planning?

Shutdown planning is the work of deciding what will be done while a plant, line or asset is stopped, and preparing it so the stop is as short and as safe as it can be. It runs from setting the event dates and budget, through building and freezing the scope, planning each job, booking access and materials, and proving readiness, to executing against a schedule and closing out with the data the next event needs.

What is the difference between a shutdown, a turnaround and an outage?

They are the same kind of event named by different industries. Mining and minerals processing say shutdown or shut, oil and gas and petrochemicals say turnaround, and power and utilities say outage. All three are a planned stop of a continuous operation to do the work that cannot be done while it runs, and the planning method is the same.

What should a shutdown checklist include?

Items organised by phase and ending at a gate: strategy (dates, budget, roles, long lead items), scope development (the register, wear measurements, the challenge), scope freeze (the signed scope and the addition process), detailed planning (job packs, isolations, access, the resourced schedule), readiness (materials kitted, contractors competent, permits pre-written, pre-shutdown work done), execution (progress by shift, addition control, discovery log) and close-out (punch list, history, intervals, lessons). Each line states what ready means and what proves it.

When should the scope be frozen?

Early enough that long lead materials can be ordered and job packs built against a fixed list, which for a major event is commonly four to six months out. The right date is set by the longest procurement or contract lead time in the scope. A freeze that is later than that means the planning is done against a moving target, and the event inherits the uncertainty.

How is scope growth controlled during a shutdown?

With one approval path that every addition goes through, whether it comes from a discovery during the work or a request from outside it. The approver judges each addition on consequence, on what it does to the critical path and on whether it can wait for the next event. Every addition is logged and counted, so scope growth is a number reported at close-out rather than a feeling.

What KPIs are used for shutdowns?

Duration against the baseline, cost against the estimate, scope growth as a share of the frozen scope, schedule adherence by shift, safety performance, start-up time and losses after hand-back, and rework. Over several events the useful measures are the trend in scope growth and in the gap between planned and actual duration, which show whether the planning is getting better.

How does a weekly schedule relate to a shutdown schedule?

The weekly schedule is the routine: work that can be done while the plant runs, planned and frozen a week ahead. The shutdown schedule holds the work that cannot be done online, planned months ahead and executed in one window. Good routine planning makes shutdowns smaller, because inspections, measurements and pre-assembly done online turn the shutdown scope from a guess into a list.

Key terms

Plain-language definitions from our glossary for the concepts this article leans on.

Standards and further reading

Related case studies and tools

Related reading

Working through something like this?

See how we approach these initiatives, or tell us what you are dealing with.
